Page 36 - Customize-Project-Plan-by-tailoring-Smartsheet
P. 36
Customize your Project Plan
by tailoring Smartsheet
12.2. Case Study - Work-Breakdown Structure (WBS)
And here is the Work-Breakdown Structure (WBS). Please just copy the column / field "Task
Name" and don't care right now for the other columns. The same goes also for the layers; just
make sure you have this list with the task names on your sheet.

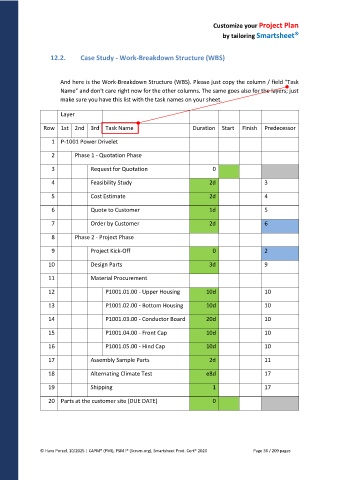

Layer
Row 1st 2nd 3rd Task Name Duration Start Finish Predecessor
1 P-1001 Power Drivelet
2 Phase 1 - Quotation Phase
3 Request for Quotation 0
4 Feasibility Study 2d 3
5 Cost Estimate 2d 4
6 Quote to Customer 1d 5
7 Order by Customer 2d 6
8 Phase 2 - Project Phase
9 Project Kick-Off 0 2
10 Design Parts 3d 9
11 Material Procurement
12 P1001.01.00 - Upper Housing 10d 10
13 P1001.02.00 - Bottom Housing 10d 10
14 P1001.03.00 - Conductor Board 20d 10
15 P1001.04.00 - Front Cap 10d 10
16 P1001.05.00 - Hind Cap 10d 10
17 Assembly Sample Parts 2d 11
18 Alternating Climate Test e8d 17
19 Shipping 1 17
20 Parts at the customer site (DUE DATE) 0
