Page 67 - Customize-Project-Plan-by-tailoring-Smartsheet
P. 67

Customize your Project Plan
                                                                                                            
                                                                               by tailoring Smartsheet

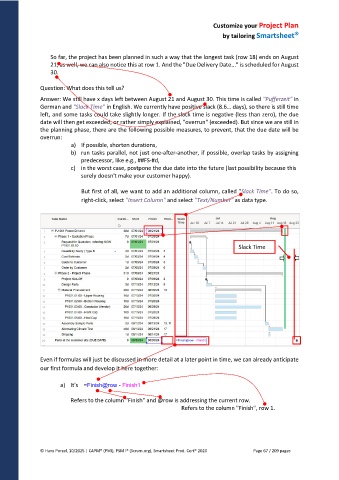

                   So far, the project has been planned in such a way that the longest task (row 18) ends on August
                   21, as well, we can also notice this at row 1. And the "Due Delivery Date..." is scheduled for August
                   30.


               Question: What does this tell us?
               Answer: We still have x days left between August 21 and August 30. This time is called "Pufferzeit" in
               German and "Slack Time" in English. We currently have positive slack (8.6… days), so there is still time
               left, and some tasks could take slightly longer. If the slack time is negative (less than zero), the due
               date will then get exceeded, or rather simply explained, "overrun" (exceeded). But since we are still in
               the planning phase, there are the following possible measures, to prevent, that the due date will be
               overrun:
                          a)  If possible, shorten durations,
                          b)  run tasks parallel, not just one-after-another, if possible, overlap tasks by assigning
                             predecessor, like e.g., ##FS-#d,
                          c)  in the worst case, postpone the due date into the future (last possibility because this
                             surely doesn't make your customer happy).

                              But first of all, we want to add an additional column, called "Slack Time". To do so,
                              right-click, select "Insert Column" and select "Text/Number" as data type.









                                                                                     Slack Time





















               Even if formulas will just be discussed in more detail at a later point in time, we can already anticipate
               our first formula and develop it here together:


                      a)  It's    =Finish@row - Finish1

                          Refers to the column "Finish" and @row is addressing the current row.
                                                                 Refers to the column "Finish", row 1.






               © Hans Porzel, 10/2025 | CAPM® (PMI), PSM I® (Scrum.org), Smartsheet Prod. Cert® 2020                                             Page 67 / 209 pages
